The Critical Path in Project Planning

Joe Gregorio

Applying the Fundamental Axioms to Reduce Uncertainty walked through the steps of using divide and conquer to reduce a large complex project into smaller inter-related tasks.

Now that we have our smaller list of tasks, one of the first thing you will want to do is look at the critical path, that is, the longest set of tasks in your plan that all depend on each other and define the longest path from start to finish in your project.

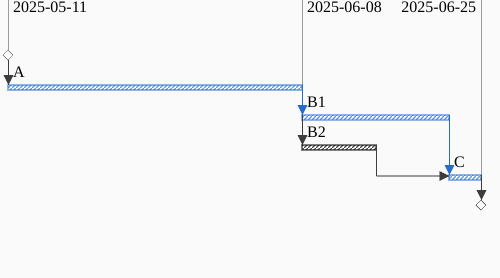

Let’s consider the following project, where we have tasks A, B1, B2, and C. Note that B1 and B2 are both “successors” of A, i.e. A has to finish before they can begin. Also note the B1 and B2 are “predecessors” of C, that is both of them much complete before task C can begin. The final thing to note is that B1 takes twice as long to complete as B2.

A->B1, A->B2, B1->C, B2->C, but B2 is half the duration of B1.

So if B1 takes four weeks to complete, B2 only takes two weeks to complete. In this case the critical path of the project is A -> B1 -> C, which you can see as highlighted in blue in the above chart. Any delay in A, B1, or C will delay the completion of the project. On the other hand, if B2 takes a few days longer than planned, actually anywhere up to taking twice as long, and the project will remain on time.

The critical path is an important tool in project planning because it tells you the tasks you really need to monitor closely because they are the ones that determine the overall project lengh. Also, these are the tasks you need to focus on when trying to shorten a project. And who among us hasn’t been on a project where you’ve planned to do the work in X days and you’re asked, what would it take to get it done in X/2 days?

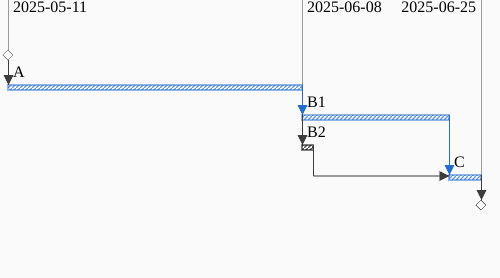

In the above example how much effort should you put into shortening task B2? Well, none, because even if you got B2 down to just a single day, that will not have any affect on when the project gets finished:

A->B1, A->B2, B1->C, B2->C, but B2 is just a sliver of the duration of
B1.

What you really want to focus on in this particular example is reducing the length of task A. It clearly makes up a large portion of the project timeline and reducing that task will have the largest impact on finishing the project sooner.

That’s the general idea of critical path analysis, find the critical path, then find the “long poles” on that critical path, that is, the longest duration tasks that appear on the critical path, and focus on shortening them to bring down the total project duration.

While simply calculating the critical path will certainly help you run your project, you must be aware of, and always on the lookout for, hidden critical paths. Let’s look again as our first example:

A->B1, A->B2, B1->C, B2->C, but B2 is half the duration of B1.

But now let’s assign a level of Uncertainty to each task. In this case we will use Jacob Kaplan-Moss’s multipliers for measuring uncertainty:

Uncertainty Multiplier(Divisor)
low 1.1
moderate 1.5
high 2
extreme 5

So what does a moderate level of uncertainty mean? If we presume a task has a duration of 6 days, then that task could be completed from anywhere from the low side of $$(6 / 1.5) = 4$$ days, or on the high side of $$(6 * 1.5) = 9$$ days.

If all the tasks in the project below have a low uncertainty except for ‘B2’ which has an extreme level of uncertainty then (totally depending on what the distribution of the uncertainty of B2 looks like), B2 may actually end up on the critical path just as often as B1.

A->B1, A->B2, B1->C, B2->C, but B2 is half the duration of B1.

That is, B2 will complete somewhere between $$[(1w / 5), (1w * 5)]$$ or somewhere in 3 to 35 days, and given that uncertainty in B2 there’s roughly a 50% chance it’s actually on the critical path.

While this might seem like a pretty academic exercise, looking for hidden on critical paths was instrumental on getting one very large profile project to finish on time: careful attention found a long pole task on a hidden critical path that could be accelerated, which we did accelerate, which was lucky because other parts of the project finished early and the hidden long pole did end up being on the critical path and our acceleration of that task turned into a huge win in getting the project done in time.
